KITCHEN. We had a banner week at
the LARTC and our professional chef is very happy!

The month gas connections were installed, inspected

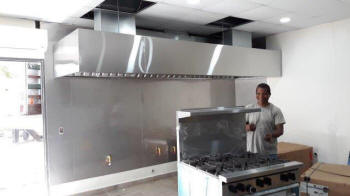

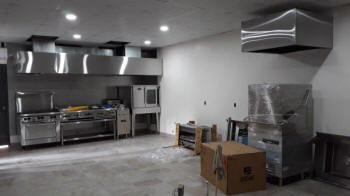

and approved. The large cooking hood/extractor and
dishwasher hood were fabricated and installed. The

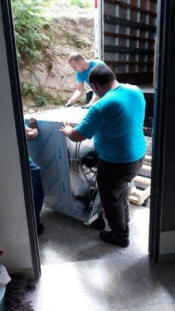

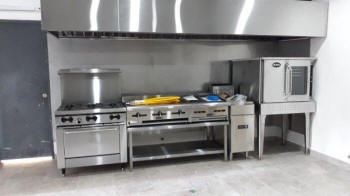

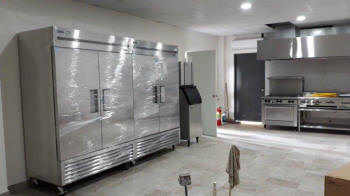

LARTC commercial kitchen equipment was delivered and
is in process of being set up and connected! In our

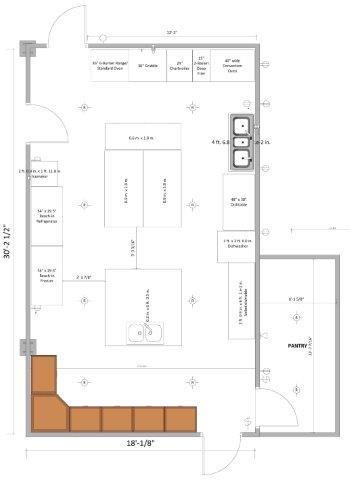

kitchen design, we’ve affectionately named the four
walls as follows.
- The COLD wall (left) features a lean-in refrigerator,
lean-in freezer and icemaker.
- The COOK wall (top) gas appliances include a six-burner
stove with standard oven, griddle, grill, fryer,
broiler (salamander) and convection oven.
- The CLEAN wall (right) includes a three-bay sink, stainless
table and canopy dishwasher with a receiving sink
and table.
- The fourth wall (bottom) is the L-shaped
COUNTER wall for
food preparation with storage cabinets below.
The kitchen will also have a square island with a double
sink and base cabinets located on the counter wall
side of the kitchen. In addition, there will be a
second island located on the cook wall side,
created using stainless tables, open underneath for
rolling cart storage.
We are grateful for the provisional kitchen that we
have been using since moving into the Center in
February 2017. However, the kitchen wasn’t adequate
for the group of 40 that attended the International
Educational Leaders Dialogue in March. The new
commercial kitchen will facilitate meals for larger
groups. We will have capacity to serve at least 200
in the Atrium when it is completed.

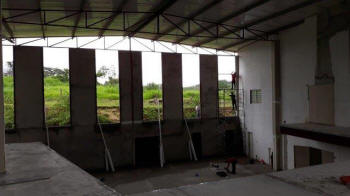

ATRIUM. Since the last update, we’re happy to report

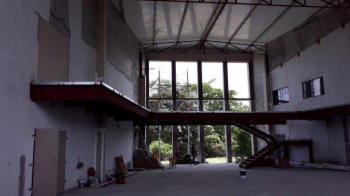

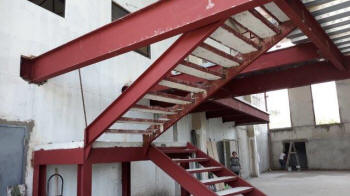

that the mezzanine I-beam structure, stairs and
concrete floor have been built! Installation of the

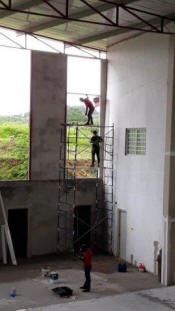

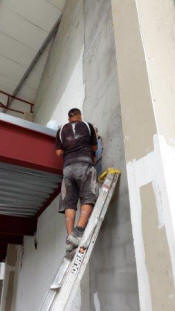

subway tiles on the five tall front columns is
nearly complete. The “topping” pre-tile layer to
level the concrete floor has been completed.

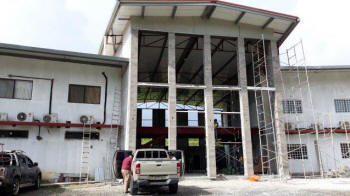

Aluminum window frames have been installed in the

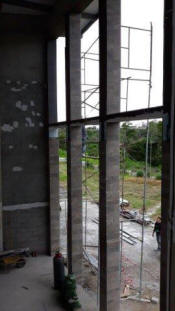

six tall vertical openings on the back wall and this
work has begun on the four tall vertical openings in
the front. Glass will be installed in the next few
days. The two sets of tempered glass double doors
for the entrance will be installed by the end of the
month. All main floor tile work should be completed
by the end of July.
PHASE FOUR TRAINING ADDITION. We have also completed
the roof, poured the floor and installed the door of
the workshop/storage room behind the addition. We
have also completed the gutters, downspouts and
drainage for the roof, very important before the
arrival of the rainy season.
TEAMS AND GROUPS. A team from Springfield Evangel
Temple arrives on July 3rd. Half of the team will be
building the L-shaped base cabinets on the counter
wall and the square island base cabinets in the
commercial kitchen. They will also build the base
cabinets for the “breakfast room” (food and beverage
staging). The other half of the team will be
painting the walls of the Atrium.
The Little Davey Project team will be returning to
Panama in mid-July, basing out of the Center,
blessing our schools with 75 new computers! We just
hosted an international group of missions leaders
who conducted a week-long seminar on missionary
care. Four weeks in August 35-40 pastors and leaders
will continue their advanced studies at our Center.
In October a church from Missouri is sending a team
to work on the second story of the training/
administration addition.
The Center offers teams and groups safe and
reasonably priced housing and meal options. These
services help to underwrite Center operations and
add a small amount to help provide furnishings for
the Center.
2019-2020 GOALS AND BUDGET… THANK YOU to all who
gave to make these construction advances possible.
We received four large offerings in March and April
that boosted our 2019-2020 construction progress.
Other individuals regularly support this project. We
have also received offerings from US Hispanic
churches and districts, even from our national
churches in Argentina and Peru, with pending
commitments from two other countries. We are
absolutely overwhelmed by the generosity of so many.
Year to date, we have invested approximately $80,000
of the overall projected $350,000 budget for
2019-2020 work. Following is a report of the
remaining work and expenses projected to complete
through phase four and essential miscellaneous work.
Phase 3 Atrium - $125,000
- Installation of column and floor tile on the main
floor and mezzanine
- Cover and paint mezzanine structure and
stairs
- Mezzanine and stair banisters
- Four glass double doors (connect to building
wings)
- Texture and paint inside walls
- Electrical conduit and wiring, outlets, switches,
lights, sound and video
- Suspended ceiling and doors for the back rooms
(bathrooms, storage and food staging room)
- Wall tile, cabinets, counters and fixtures/plumbing
for the bathrooms and food staging room

- Air conditioning
- Furnishings and miscellaneous
Commercial Kitchen - $5,000
- L-shaped and first island cabinets (paid for by July
team)
- Counters
- Stainless tables for second island
- Pantry shelving
- Carts and other furnishings
Phase 4 Training Addition - $70,000
- First story concrete floor
- Second story flooring structure and concrete
- Second story exterior walls
- Floor tile for both floors
- Inside sheetrock walls
- Electrical, plumbing, fixtures and air conditioning
- Windows, doors and suspended ceiling
Essential Miscellaneous Work – $70,000
- Perimeter security wall and entrance
- Retention wall
- Building façade and painting
- Road, parking, sidewalks and lighting
We are trusting God to provide the additional
$270,000 needed to complete our 2019-2020 goals. At
the beginning of our missionary career, someone once
shared an illustration that applies to this great
need that we face now. We were learning Spanish in
Costa Rica and had shared in one of our Panorama
newsletters how it seemed almost impossible. The
person asked, “How do you eat an elephant? ...
One bite at a time!” In the years following,
we’ve learned the secret of listening to God’s
voice, being obedient no matter how impossible it
seems and depending upon Him to provide what is
needed to make it happen.
God has used so many of YOU to make it happen. Thank
you! Will you help us again? Together, we
are influencing and empowering leaders, training and
inspiring teachers and harvest workers, and
equipping them with the tools and resources they
need!
Online giving…
http://s1.ag.org/lartc
Assemblies of God World Missions
Project 14295 – LARTC
1445 Boonville Ave
Springfield, MO 65802
|
