|
LARTC Update... Finishing Well
Rod and Sherry Boyd
2019
is just days away! Transitioning from one year to the
next always provides moments to both think back and think
forward. One of my spiritual fathers told me (Rod)
many years ago, "People won't remember how you start,
just how you finish... So finish well." That's
still great advice!
We are finishing 2018 very well!
As we look back at how God has provided for the construction of the Latin
America Resource & Training Center, we continue to be amazed by His
miraculous provision. We have had three main areas of focus in 2018:
-
Atrium.
January through April we installed the Atrium foundation, roof columns,
roof, back-left wall and upper side-wall stucco. The open space
defined by the high roof makes quite a statement!
-
Drainage. May through August

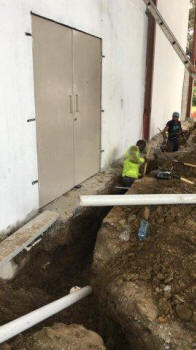

we installed building gutters, downspouts, underground drain pipes and
culverts. Lake LARTC has dried up and the torrential tropical rain
water is being effectively managed.
-
Housing. Construction resumed
in October on the second floor of the Phase Two Housing Building.

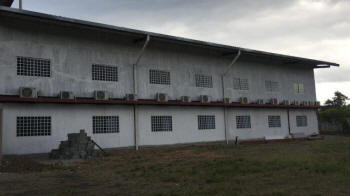

We continue to see significant progress from week to week. All block,
stucco and plumbing work was completed by the end of November with base
paint. All windows were installed and electrical work was

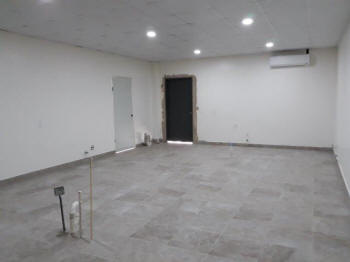

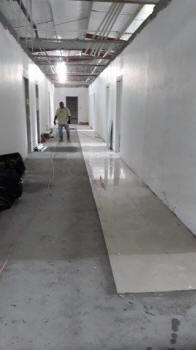

completed by mid-December. Floor tile and suspended ceiling work
has been completed in seven rooms. The other seven rooms should be
far along by the end of the year. Thirty-nine 30" wide closet
units have been built and will be installed in the next couple of weeks,
three units in each of the 13 new guestrooms.
$50,000 Matching Fund. The housing
work has been accomplished thanks to a significant offering received from a
church in the midwest. Current construction progress stands at 70%
overall (see graphic below), up from about 53% the end of 2017. We
have enough funds to finsih construction of the housing building, but still
need help to furnish it! We have purchased closets, but will need help
to purchase beds, nightstands and desks for the 13 rooms. Half of the
matching fund will go to this need. The other half will be used to
continue construction of the Atrium. As of December 20th, we've
received $7,220 that with the match totals $14,440. The match will
continue until March 1st. We DO need your help. Please visit
http://s1.ag.org/lartc to give your
offering. Buy a twin bed and mattress set for $450.00, the match pays
for a second! Thank you for your help!
Looking
ahead to 2019. We have sufficient funds to complete
construction of the second floor of the housing building that will provide
13 new guestrooms, maid's room/storage and guest laundry. Following is
a list of the work that remains:
-
Floor tile and suspended ceiling work will be
completed in the remaining seven rooms.
-
Interior doors, lighting and painting.
-
Bathroom fixtures and countertops have been purchased
and will be installed.
-
Kitchenette cabinets will be installed in the two
suite units.
All work should be completed by February 15th, just
in time for us to host the 2019 International Dialogue for Educational
Leaders. We are expected 35-40 National Superintendents, National
Cristian Education Directors and our International Ministry Training Team to
attend. Our ability to host this meeting saves us thousands of
dollars!
Priority
projects.
-
Atrium. If all funds come in
for the matching campaign, we will have $50,000 to continue Atrium

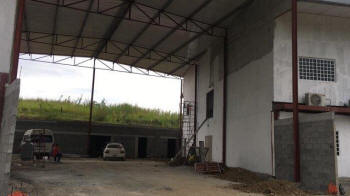

construction. Our first priority is to enclose the front and back
of the Atrium that will secure the entire building. Work will
begin on the stairs and bridge/mezzanine that will connect the second
floors of the Training/Administration and Housing buildings. Our
hope is to be able to complete the flooring, plumbing, electrical,
furnishings and some additional features by the end of 2019, making the
Atrium useable. Total cost is estimated at $150,000.
-
Commercial
Kitchen. We also need to purchase cabinets and appliances
for the commercial kitchen located on the first floor of the housing
building. We continue to pray that a women's ministries group or
groups would adopt the new kitchen! We estimate the cost at
approximately $30,000.
-
Phase Four - Training/Administration Building
Addition. Based upon teams and funding, we may also start
construction of the 4,800 sq. ft. addition on the back side of the
Training/Administratiion building.
Once
again, we thank all who have been a part of this dream. We have
frequently described the LARTC project as a field of dreams.
Even our dream has a limited view of sight. We aren't able to look
around the curve. But God has known all along how this new Center will
bless hundreds of leaders and thousands of teachers, providing them with a
reasonably priced venue for training and inspiration, and a clearinghouse
for resources and services.
Please agree with us in faith that God will provide the
final 30% to finish the dream. Help us finish well!
|
